Permitted Development Explained: 2026 Guide

Written by Albjon (Albie) Meziu
Managing Director, DKM Builders Oxford Ltd
Principal Contractor specialising in high-value residential projects in Oxford
14 minute read
Introduction
The first question we get asked at almost every site visit in Oxford is not "how much will it cost?" It is "will we need planning permission?" It is the right question to ask first. The answer decides what drawings you need, how long the project takes to reach site, and sometimes whether the extension you have in mind can be built at all.
The honest answer is that a lot of house extensions in Oxfordshire never go near a planning application, because they fall within permitted development. Plenty of others do need one, and in Oxford, with its conservation areas, its listed terraces and the Green Belt villages around it, more do than most people expect.
This guide explains what permitted development actually is, what you can build under it in 2026, where the rules tighten in Oxford and Oxfordshire, and how to get a definite answer before anyone orders a skip. It is written by a builder, not a planning consultant. We build to approved drawings every week, we see what happens when the paperwork is wrong, and when a project needs a planning professional we say so.
What Is Permitted Development?
Permitted development is planning permission that has already been granted. The national rules, set out in the General Permitted Development Order, give every house in England a set of things its owner can build without asking the council, provided the work stays within fixed limits on size, height, position and materials. Fit inside every limit and you can build. Go over any one of them, even by a little, and you need a planning application.
That is the part people miss. Permitted development is not the absence of rules. It is planning permission granted in advance, on conditions, and it is lost the moment one of those conditions is not met. A rear extension that is 3.2 metres deep instead of 3 is not "roughly permitted development". It is unauthorised.
Two other things are worth saying at the start. Building Regulations approval is a completely separate process, and every extension needs it whether or not planning permission is required. And the only certain answer to "do I need planning permission?" is a Lawful Development Certificate or a planning decision from your council. Everything else, including this guide, is a good indication.
Planning Permission, Permitted Development and Building Regulations: What Is the Difference?
Planning permission is the council's consent for the size, appearance and effect of a change to your house: how it looks from the street, what it does to the neighbours' light and privacy, whether it suits the area. In Oxford the council is Oxford City Council. Elsewhere in the county it is Cherwell District Council for Banbury, Bicester and Kidlington, South Oxfordshire District Council for Thame, Didcot, Henley and Wallingford, the Vale of White Horse District Council for Abingdon, Wantage and Faringdon, and West Oxfordshire District Council for Witney, Woodstock, Chipping Norton and Burford.
Permitted development is that same permission granted in advance by national rules for projects within set limits. The limits are the same everywhere in England, but a council can remove them locally, and they are tighter in protected areas.
Building Regulations are about how the extension is built: foundations, structure, insulation, fire safety, drainage, ventilation, glazing and electrics. They apply to every extension and are checked during the work by Building Control, either the council's own inspectors or a registered building control approver. Our case study of a loft conversion in Banbury shows what those inspections involve. Planning permission does not give you Building Regulations approval, and the reverse is also true.
There is a fourth agreement that has nothing to do with the council. If your extension is built up to or astride a shared boundary, or its foundations go in close to a neighbour's building, the Party Wall etc. Act 1996 requires you to serve notice on the neighbour. We are pricing a terrace in Stadhampton at the moment where the new extension meets a neighbour on each side, and that means two Party Wall notices before a spade goes in the ground. It is the owner's responsibility, it is separate from planning, and it is worth starting early.
What Can I Build Without Planning Permission in 2026?
Everything below is measured against the original house, which means the house as it was first built, or as it stood on 1 July 1948 if it is older than that. Any extension added since then, by you or by a previous owner, has already used up part of the allowance. A 1990s conservatory counts.
How big can a single-storey rear extension be under permitted development?
A single-storey rear extension can go 3 metres beyond the original rear wall of a semi-detached or terraced house, or 4 metres for a detached house, without a planning application. It can be no higher than 4 metres, and if any part of it is within 2 metres of a boundary, the eaves can be no higher than 3 metres. This is the extension most Oxford kitchens are built in, and on a house with no earlier additions it is usually straightforward.
What is the larger home extension scheme?
If you need more depth, the larger home extension scheme allows a single-storey rear extension of up to 6 metres on a semi-detached or terraced house, or 8 metres on a detached one. It is not automatic. You tell the council what you intend to build, the council writes to the neighbours, and if there are no objections it confirms within 42 days that you can go ahead. If a neighbour objects, the council considers the effect on them before deciding. The scheme is not available in conservation areas or on other protected land.
Can I build a two-storey rear extension without planning permission?
Sometimes, but on Oxford's terraces it is rare. A two-storey rear extension is permitted development only if it extends no more than 3 metres beyond the original rear wall, stays at least 7 metres from the rear boundary, matches the roof pitch of the house, and has obscure glazing in any upper-floor side windows. Short gardens fail the 7-metre test, and the right does not exist at all in a conservation area. Most two-storey extensions we build have been through a planning application.
Are side extensions permitted development?
A side extension can be permitted development if it is single storey, no more than 4 metres high and no wider than half the width of the original house. The catch is the wrap-around. Once a rear extension turns the corner and runs along the side as well, it is judged as a side extension too, and it usually fails the limits. Side extensions are not permitted development in conservation areas.
Do I need planning permission for a porch?
Not if the porch is no more than 3 square metres in floor area, no more than 3 metres high, and no part of it is within 2 metres of a boundary with a road or footpath. A porch that replaces an old one on the same footprint is still measured against those limits.
Do I need planning permission for a garden room, home office or outbuilding?
Usually not. A garden building is permitted development if it is single storey, its eaves are no higher than 2.5 metres and it is no taller than 4 metres with a pitched roof or 3 metres with any other roof. If it sits within 2 metres of a boundary, the whole thing is limited to 2.5 metres high. It cannot go in front of the house, and its use has to be incidental to the house, which is where garden rooms go wrong. An office, a gym or a studio is fine. The moment it has a bed and a shower it is living accommodation, and living accommodation needs planning permission. In a conservation area an outbuilding cannot be at the side of the house.
Does a garage conversion need planning permission?
Converting the inside of a garage is not development at all, and swapping the garage door for a wall and window that match the house usually falls within permitted development. What catches people out is the planning history. A great many estates built in Oxfordshire since the 1980s were approved with a condition that keeps the garage for parking, and we have lost count of the garage conversions where the first thing we found on the council's website was exactly that condition. Check before you start, and remember that Building Regulations apply to every garage conversion whatever the planning position.

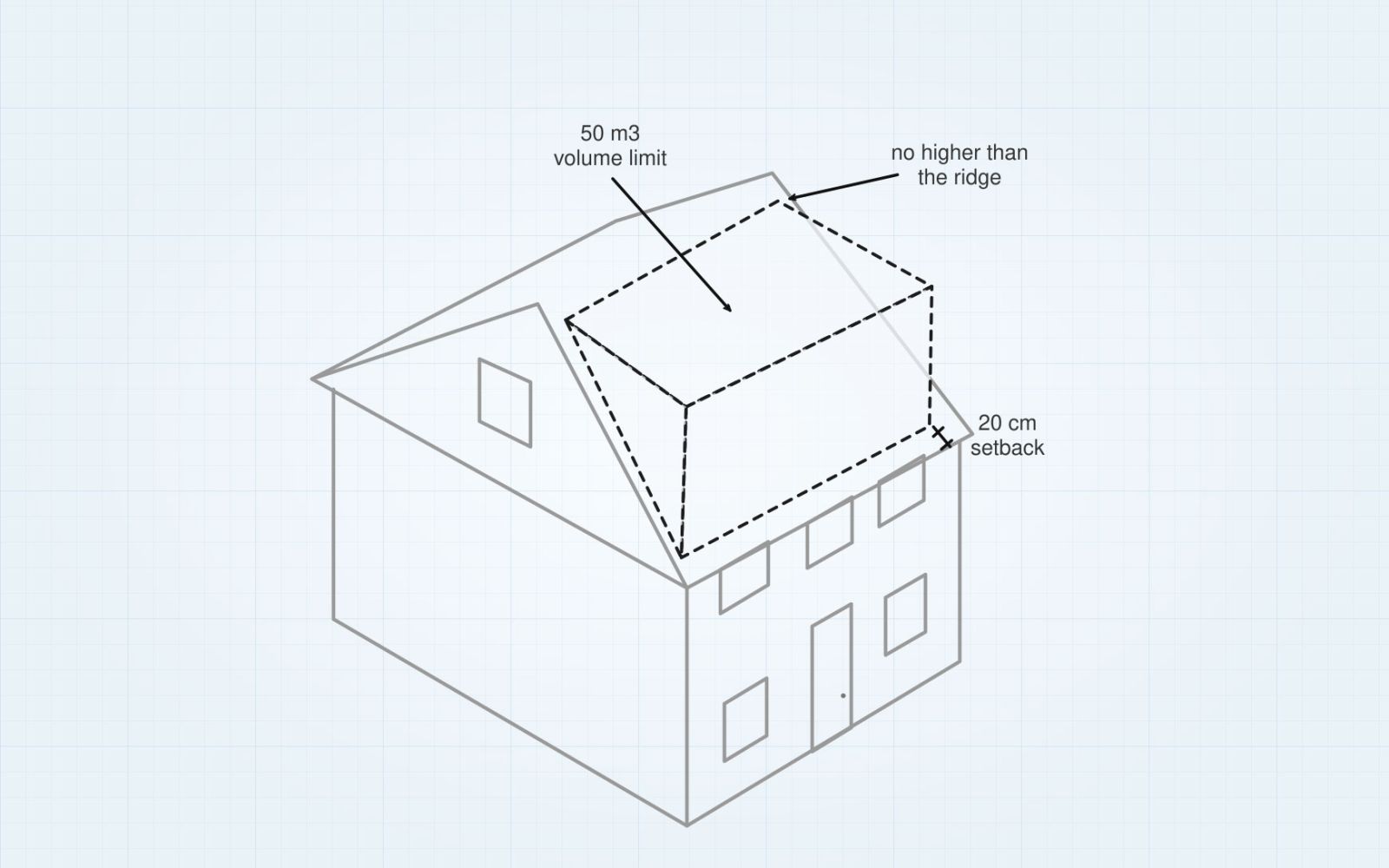

Is a loft conversion or dormer permitted development?
Often, yes. You can add up to 40 cubic metres of roof space on a terraced house or 50 cubic metres on any other, as long as there is no dormer on the elevation facing the road and nothing rises above the existing ridge. A rear dormer with Velux windows to the front is the classic permitted development loft. This month we priced a loft in Botley where the architect had sketched dormers to the front as well as the back; the rear dormer is permitted development, the front ones face the road and need an application the council may well refuse, so we advised putting the money into the rooms instead. None of these rights apply in a conservation area. Our loft conversion pages and our loft conversion cost guide cover the detail.
Can I add an extra storey without planning permission?
A national right introduced in 2020 allows one extra storey on most houses built between 1948 and 2018, subject to the council's prior approval of the design and its effect on the neighbours. It does not apply in conservation areas and it is rarely straightforward in practice. Treat it as a planning application and you will not be disappointed.
The conditions that apply to every permitted development project
Whichever of the projects above you are planning, the same general conditions sit over the top of it:
- Nothing may be built forward of the front of the house, or of a side wall that faces a road.
- The new work, together with every earlier extension and outbuilding, must not cover more than half the garden and land around the original house.
- Nothing may be higher than the highest part of the existing roof.
- The materials must be similar in appearance to the existing house, with a conservatory the usual exception.
- No balconies, verandas or raised platforms. A ground-level patio is fine; a terrace on the extension roof is not.
- The rights apply to houses only. Flats and maisonettes have no permitted development rights for extensions, and neither does a house that has been split into flats.
If your project meets every line, you may build without applying. If it fails any one of them, you need planning permission, or you need to change the design until it fits.
Where Are the Rules Tighter in Oxford and Oxfordshire?
Conservation areas in Oxford
Oxford has more than a dozen conservation areas, among them the city centre, the North Oxford Victorian Suburb, Jericho, Walton Manor, St Clement's and Iffley Road, Headington Hill, Old Headington, Old Marston, Iffley village, Osney Town, Wolvercote and Temple Cowley. The market towns and villages have their own, from Banbury, Deddington and Woodstock to Henley, Thame, Wallingford and Abingdon.
Inside a conservation area the national rules change. There are no side extensions, no rear extensions of more than one storey, no cladding, no larger home extension scheme and no dormers under permitted development. A single-storey rear extension within the standard limits is still usually permitted, but demolition, boundary walls and trees all need their own notices or consents, and the council will notice.
Listed buildings
A listed house needs listed building consent for any work that affects its character, inside or out, whether or not that work would otherwise be permitted development. Oxford's terraces in Jericho, St Clement's and the city centre include many listed houses, and so do the stone villages along the Cotswold edge. Treat every change to a listed house as needing consent until a conservation officer tells you otherwise.
National Landscapes: the Cotswolds, the Chilterns and the North Wessex Downs
The Cotswolds National Landscape covers much of west Oxfordshire, the Chilterns take in the south east of the county around Henley and Watlington, and the North Wessex Downs reach the Vale around Wantage. In these areas the same restrictions apply as in a conservation area, and outbuildings more than 20 metres from the house are limited to 10 square metres.
Article 4 directions
A council can remove specific permitted development rights in a defined area with what is called an Article 4 direction. Oxford City Council and each district council publish theirs. If your street is covered, a project that would be permitted development anywhere else needs an application.
Newer housing estates
When a housing estate is approved, the permission often includes a condition removing permitted development rights for extensions, garage conversions or outbuildings, so that the council keeps control of parking and of how the estate looks. It is common on the newer estates in Bicester, Didcot, Witney, Kidlington and Banbury. The planning history of your house, which is public on the council's website, will show it.
The Oxford Green Belt
The Oxford Green Belt surrounds the city and takes in villages such as Wheatley, Cumnor, Kidlington and Islip. Permitted development still applies there. Once an application is needed, though, the council will only approve an extension that is not a disproportionate addition to the original house, and each council has its own view of where disproportionate begins. Ask before the drawings are made, not after.
How Do I Know for Certain Whether I Need Planning Permission?
Start with the planning history. Every council in Oxfordshire has an online planning register. Search your address, read every decision and every condition, including the ones attached to the estate as a whole, and you will settle most doubts in twenty minutes.
If you believe your extension is permitted development, ask the council to confirm it with a Lawful Development Certificate. It costs half the fee of a planning application, is usually decided within eight weeks, and it is a legal document that a buyer's solicitor will accept when you sell. We recommend one for every extension built under permitted development. Without it you are relying on your own reading of the rules, and the person who questions that reading may be a buyer ten years from now.
For anything with room for argument, use the council's pre-application service. Oxford City Council and the district councils all charge for it, and for a two-storey extension, a house in a conservation area or anything unusual, an officer's written view before the drawings are finished can save a refusal and a redesign.
And if you like detail, read the government's technical guidance for householders. It has diagrams, it is the document planning officers use, and it answers most of the awkward cases: what counts as the rear wall of an L-shaped house, how height is measured on a sloping garden, and when a side extension becomes a wrap-around.
What Happens If I Do Need Planning Permission?
A householder planning application is the route for extending or altering a single house. It needs a location plan, a block plan, existing and proposed floor plans and elevations, an application form and the fee. The national householder fee is a few hundred pounds, the Planning Portal shows the current figure and adds a small service charge, and larger extensions can trigger the Community Infrastructure Levy, though house extensions are normally exempt provided the exemption is claimed before work starts.
Once the council has validated the application it writes to the neighbours, puts up a site notice and has a target of eight weeks to decide. Straightforward householder applications usually come back within that time; a contentious one can be extended by agreement. A permission normally lasts three years from the decision date, and the work must have started before it runs out.
The conditions matter as much as the decision. A permission may fix the materials, require obscure glazing, restrict hours of work or require samples to be approved before you start. We always ask to see the decision notice, not just the drawings, because building something slightly different from what was approved can leave an extension without a valid permission at all.
What gets an extension approved in Oxford?
From the builder's side of the table, three things get extensions approved in Oxford more than anything else. The design is clearly subordinate to the house: lower, narrower and set back, with the roof form following the original. The neighbours are respected: no new windows overlooking their gardens at close range, and no wall that cuts the daylight to their nearest window, which officers test with the 45-degree rule. And the materials match. In a brick terrace that means matching brick and bond; in a stone village it means stone, not render.
The Permitted Development Mistakes We See Most Often
Measuring from the wrong wall. The conservatory a previous owner added in 1998 already used 3 metres of the rear allowance, so the new 3-metre extension needs permission. Permitted development is measured from the original house, every time.
Wrapping round the corner. A rear extension that also runs along the side of the house becomes a side extension as well, and usually fails the limits.
Calling a bedroom a garden room. An outbuilding under permitted development has to be incidental to the house. The moment it has a bed and a shower it is living accommodation and needs permission.
Building first and asking afterwards. A Lawful Development Certificate is for proposed work. Once the extension is up, the route is a certificate of existing lawful use, which is harder and more expensive to prove.
Ignoring the conditions on the estate. The planning history of a modern house includes the permission for the whole estate, and that is where the condition removing your rights will be.
Buying a house with an unapproved extension. Since April 2024 a council can take enforcement action against unauthorised building work for ten years after it is finished, not four; work completed before then keeps the old four-year limit. If you are buying a house with an extension and no paperwork, ask for the permission or the certificate, and if there is neither, ask a solicitor about indemnity insurance before you exchange.
Treating permitted development as no rules. The materials, height and boundary conditions still apply, and the council can require an extension to be altered or taken down if they are missed.
How Does Planning Affect the Cost and Timing of an Extension?
Planning permission adds time before the build rather than cost within it. Allow two to four weeks for measured drawings, eight weeks for the decision and some time for any redesign, and a project that needs permission is realistically three to five months from first sketch to a start on site, longer if the Building Regulations drawings and structural design follow on afterwards. A permitted development project with a Lawful Development Certificate can be on site in half that time.
The drawings are an investment either way, because the same set becomes the Building Regulations drawings and the basis of a fixed price. Our guide to how much a house extension costs in Oxford explains what a fixed price includes, and our guide to choosing a builder in Oxfordshire explains why we will not price an extension from a sketch.
How DKM Builders Approaches Planning and Permitted Development
We are builders, and planning advice is a professional service in its own right. What we do is make sure a project starts with the right question and reaches site with the right paperwork. Through our design and build service we bring in the architect and, where needed, a planning consultant, take the project through the application or the Lawful Development Certificate, and follow with the Building Regulations drawings and the structural design, so that the price we give you is for the extension the council has approved.
We then build to the approved drawings and the conditions on the decision notice, and we hand over the Building Control completion certificate at the end. That combination is what a buyer's solicitor asks for when you sell, and it is the difference between an extension that adds value and one that has to be explained.
Frequently Asked Questions
Do I need planning permission for a single-storey rear extension in Oxford?
Not usually, if it extends no more than 3 metres beyond the original rear wall of a semi-detached or terraced house (4 metres for a detached house), is no higher than 4 metres, uses similar materials, and the house is not a flat, a listed building or covered by an Article 4 direction. In a conservation area the same single-storey limits apply. A Lawful Development Certificate confirms it in writing.
How big an extension can I build without planning permission?
Up to 3 or 4 metres to the rear as standard, or 6 or 8 metres for a single storey under the larger home extension scheme with the council's prior approval, provided the house is not in a conservation area or other protected land and all the other conditions are met.
Do I need planning permission in a conservation area in Oxford?
Often. Side extensions, two-storey rear extensions, dormers and cladding are not permitted development in a conservation area, and demolition and work to trees need their own consents. A modest single-storey rear extension, a porch or a garden room behind the house can still be permitted development, and a Lawful Development Certificate is the way to be sure.
How long does planning permission take in Oxfordshire?
The council has a target of eight weeks from validation for a householder application. Add the time for drawings before submission and for discharging any conditions afterwards.
How much does a householder planning application cost?
The fee is set nationally and published on the Planning Portal; it is a few hundred pounds. A Lawful Development Certificate for proposed work costs half that. Drawings and any pre-application advice are separate.
If my extension is permitted development, do I still need Building Regulations approval?
Yes. Every extension needs Building Regulations approval and inspection, whatever its planning status. The two processes are run by different departments and can happen in parallel.
Does planning permission expire?
Yes. A householder permission normally lasts three years from the decision date. The work must have started, in a meaningful way, before it runs out.
Who is my local planning authority?
Oxford City Council for the city; Cherwell District Council for Banbury, Bicester and Kidlington; South Oxfordshire District Council for Thame, Didcot, Henley and Wallingford; the Vale of White Horse District Council for Abingdon, Wantage and Faringdon; and West Oxfordshire District Council for Witney, Woodstock, Chipping Norton and Burford.
Final Thoughts
An extension that needed permission and never got it is a problem that surfaces on the day you sell, and it is entirely avoidable. Check the planning history, measure from the original house, get the certificate or the permission, and build exactly what was approved.
Start Your Project
DKM Builders Oxford Ltd builds house extensions, loft conversions and refurbishments across Oxford and Oxfordshire, and can take a project from first sketch to planning approval, Building Regulations sign-off and a finished build through one team. If you are planning an extension and want to know where you stand, contact us and we will tell you what looks possible before anyone draws anything.
Sources and Further Reading
- Permitted development rights for householders: technical guidance (Ministry of Housing, Communities and Local Government) – https://www.gov.uk/government/publications/permitted-development-rights-for-householders-technical-guidance
- The Town and Country Planning (General Permitted Development) (England) Order 2015, Schedule 2, Part 1 – https://www.legislation.gov.uk/uksi/2015/596/schedule/2/part/1
- Lawful Development Certificates (Planning Portal) – https://www.planningportal.co.uk/permission/lawful-development-certificates
- Planning Portal: householder applications and current fees – https://www.planningportal.co.uk/
- Oxford City Council: planning – https://www.oxford.gov.uk/planning
- Party walls and building work (GOV.UK) – https://www.gov.uk/party-walls-building-works
Latest Insights
-
Permitted Development Explained: 2026 Guide
-
Full House Refurbishment Cost in Oxford: 2026 Guide
-
Loft Conversion Costs in Oxford: 2026 Guide
-
EnerPHit Retrofit in Oxford: How DKM Builders Is Delivering One of North Oxford’s Most Ambitious Sustainable Home Transformations
-
From Retrofit to Passivhaus: Why Dkm Builders Joined the Green Register
-
What to Look for When Choosing a Builder in Oxfordshire
-
How Much Does a House Extension Cost in Oxford? A 2026 Guide by DKM Builders
